Bullet Train Project: Track laying begins in Gujarat, first section to open by 2026

Kush Singh by Kush Singh
April 30, 2026
in Bullet Train, Development
0 0
0
Share on FacebookShare on Twitter

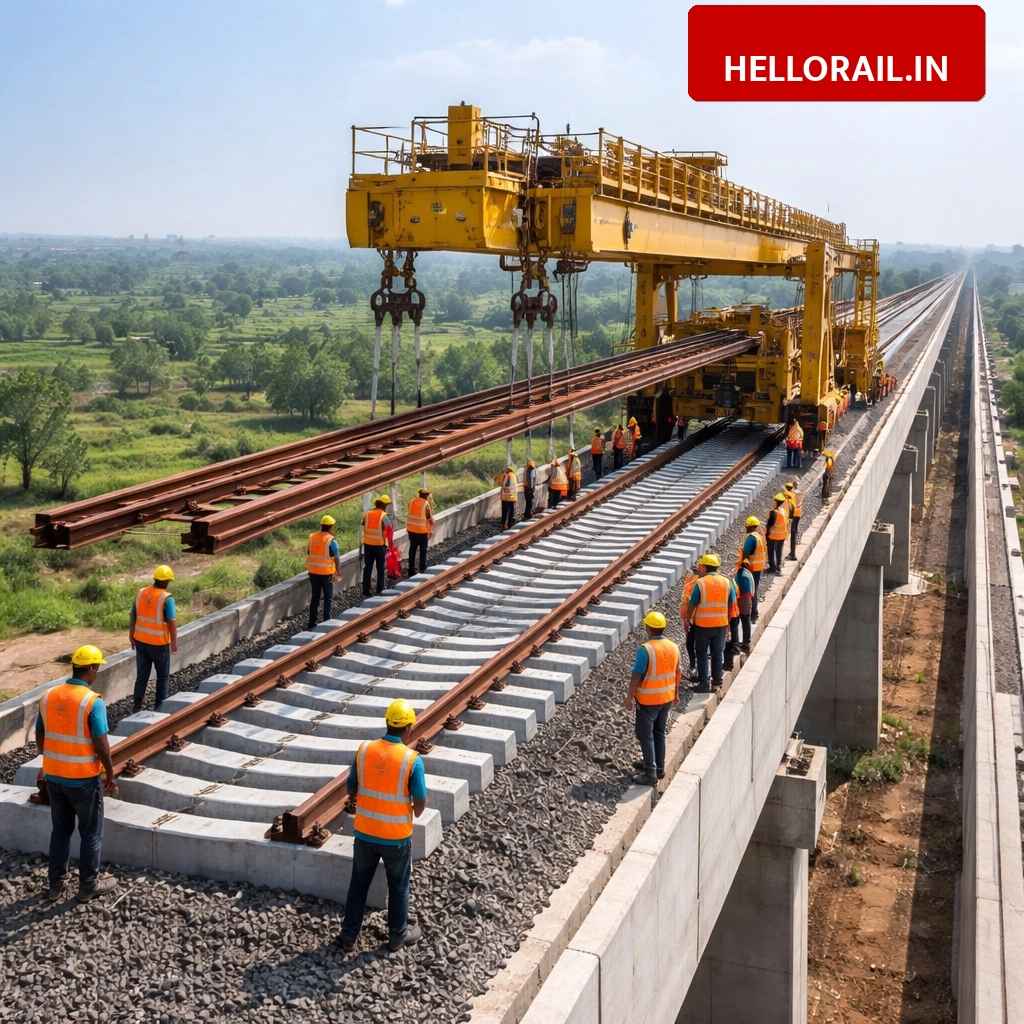

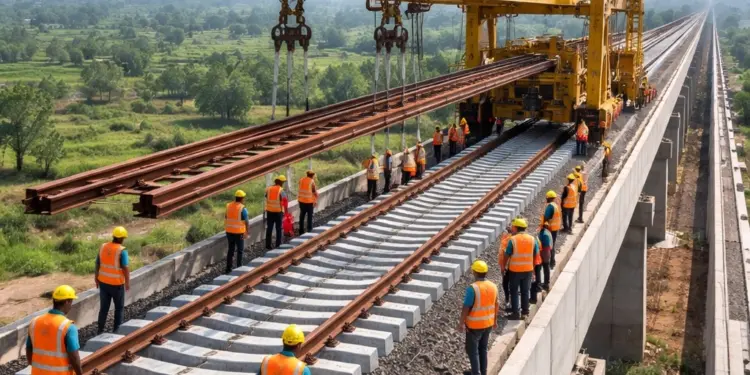

The Mumbai-Ahmedabad High-Speed Rail (MAHSR) project is moving forward quickly. Work has now entered a critical stage with the start of track laying using the Japanese J-slab ballastless system. This project will connect Mumbai and Ahmedabad, reducing the travel time to about two hours with trains running at 320 kmph.

ADVERTISEMENT

📰: Coal Transport Update: BCCL and South Eastern Railway to implement new strategy for faster movement।

What is the current progress of the project?

As of April 24, 2026, the project has reached 59.1% physical progress. The National High Speed Rail Corporation Limited (NHSRCL) has completed 439 km of piers and 347 km of viaduct. Additionally, 17 river bridges and 13 steel bridges are now complete. All 1389.5 hectares of required land have been acquired and all statutory clearances are in place.

ADVERTISEMENT

When will the Bullet Train start running?

The first section of the corridor in Gujarat is expected to open in 2026. Railway Minister Ashwini Vaishnaw stated that an inaugural 100-km run between Surat and Vapi will happen by August 2027. Maharashtra Chief Minister Devendra Fadnavis mentioned that the entire project could be completed by the end of 2028.

Key project details and partners

Feature Details
Operational Speed 320 kmph
Technology Japanese Shinkansen E5
Total Length 508.17 km
Rolling Stock Partner BEML Limited
Funding Partner JICA (Japan)
Total Investment Over Rs 90,300 crore spent

Frequently Asked Questions (FAQs)

What is the expected speed of the Mumbai-Ahmedabad Bullet Train?

The trains will operate at a maximum speed of 320 kmph using the Japanese Shinkansen E5 technology.

Which company is handling the production of the trains?

NHSRCL awarded the tender to BEML Limited for the design, production, and long-term maintenance of the rolling stock.

{“@context”: “https://schema.org”, “@type”: “FAQPage”, “mainEntity”: [{“@type”: “Question”, “name”: “What is the expected speed of the Mumbai-Ahmedabad Bullet Train?”, “acceptedAnswer”: {“@type”: “Answer”, “text”: “The trains will operate at a maximum speed of 320 kmph using the Japanese Shinkansen E5 technology.”}}, {“@type”: “Question”, “name”: “Which company is handling the production of the trains?”, “acceptedAnswer”: {“@type”: “Answer”, “text”: “NHSRCL awarded the tender to BEML Limited for the design, production, and long-term maintenance of the rolling stock.”}}]}
